Steel Mezzanines for Burnaby & Coquitlam Warehouses: A Builder's Guide

Adding a steel mezzanine to a Burnaby or Coquitlam warehouse? How structural platforms get engineered, permitted, and fabricated to free up floor space.

When a Burnaby warehouse or a Coquitlam light-industrial unit runs out of floor, the cheapest square footage available is usually directly overhead. A steel mezzanine turns the empty volume above the slab into usable area, storage, an office, a production platform, without expanding the building or breaking a lease to find a bigger space. In Metro Vancouver’s industrial market, where space is tight and expensive, that math gets attractive fast.

But a mezzanine is a structural addition, not a shelf. Here’s how one actually gets built.

It starts with the engineer, not the steel

The first thing a mezzanine needs is a design load. A structural engineer sets that based on what the platform will actually do, light archive storage, heavy pallet racking, an office full of people and desks, or a piece of equipment with point loads all demand different numbers under the BC Building Code. That load drives everything: the beam sizes, the column spacing, the deck, and the footings.

This is why we won’t quote a mezzanine off a sketch. The use determines the load, the load determines the steel, and the steel determines the cost. Get the load wrong, or guess it, and you either overspend on steel you don’t need or build a platform that can’t legally hold what the client intends to put on it.

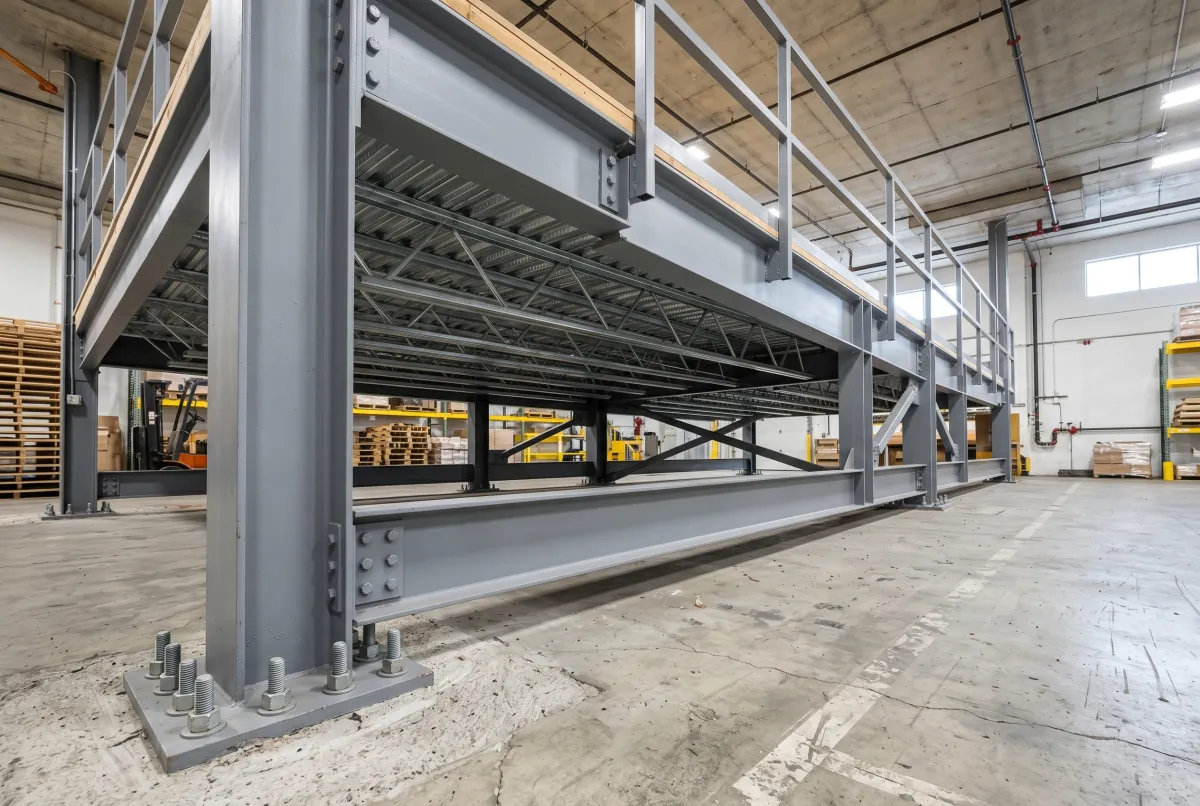

Underside view of a steel mezzanine showing the beam-and-column grid and a column baseplate bolted to a Coquitlam warehouse floor

Freestanding vs. building-supported

There are two basic ways to carry the load down.

A freestanding mezzanine stands on its own columns and footings. The existing building doesn’t take any of the platform’s weight. For a leased unit in a Coquitlam or Port Moody business park, this is often the easier path, the landlord’s structure is untouched, and the platform can sometimes be treated as removable equipment depending on how it’s detailed. It uses more steel, but it isolates the loads cleanly.

A building-supported mezzanine ties into the existing columns, walls, or roof structure. It can save steel and floor space, but only if the existing building can actually take the added load. That means the engineer has to verify the original structure, which, in an older Burnaby industrial building, isn’t always documented well. We’ve walked into buildings where the only way to confirm the existing capacity was to expose and measure connections.

Most of the time, for a tenant fit-out, we land on freestanding for the cleaner permit story.

The permit is half the timeline

A mezzanine requires a building permit and engineered, P.Eng.-sealed drawings in every municipality we work in. The review isn’t a rubber stamp, it looks at the structural design, how the platform affects the existing building, the new occupancy it creates, and the fire and egress consequences.

That last point surprises owners. Adding an intermediate floor can change the building’s occupancy classification and trigger requirements for sprinkler coverage above and below the deck, additional exits, and fire separations. We’ve seen mezzanine projects where the sprinkler revisions cost as much as the steel. None of that is a reason to avoid a mezzanine, it’s a reason to do it with proper drawings and a real permit, so the requirements surface during design instead of at final inspection.

In practice, the permit review often takes as long as the fabrication. We use that time, the steel gets detailed, cut, and welded in our Burnaby shop while the application is in review, so the platform is ready to install when the permit clears.

The platform, the deck, and the access

The mezzanine isn’t just beams and columns. The deck on top depends on the use: bar grating for storage where you want air and light to pass through, a composite steel-and-concrete deck for heavier or fire-rated applications, or a structural deck with finish flooring for an office. Each changes the load and the framing, so it’s decided with the engineer early.

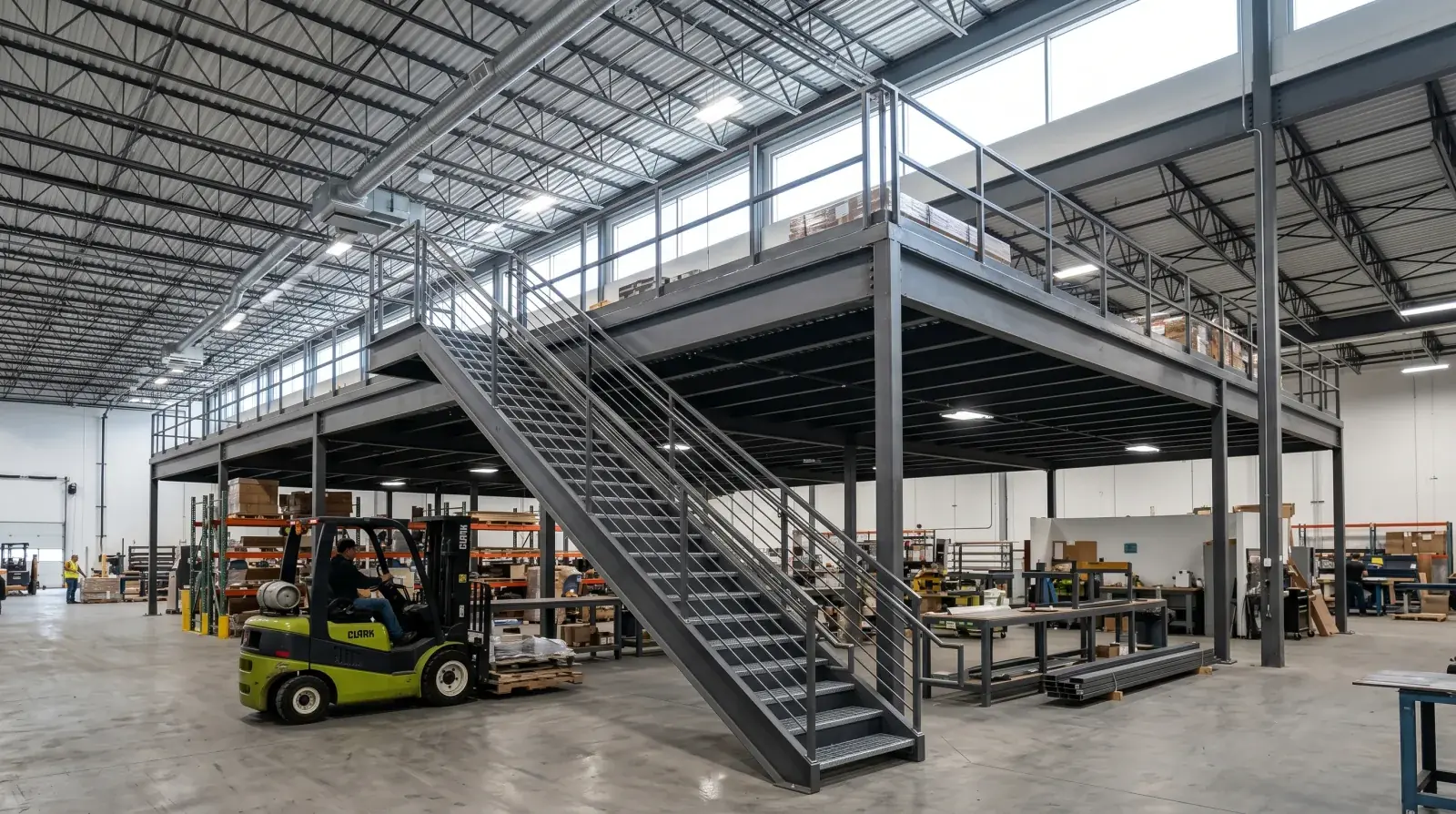

Then there’s getting up there. Every mezzanine needs a stair, and the open edges need a guard. The guard has to meet the BC Building Code height and load requirements, and the stair needs a continuous graspable handrail, the same graspability rules that apply to any stair. For industrial platforms, the guard also has to resist horizontal loads from people leaning and equipment bumping. We fabricate the stair and guard as part of the mezzanine package so the whole assembly meets code as one system, rather than bolting on an off-the-shelf rail that doesn’t quite comply.

Installing without shutting you down

Owners worry that a mezzanine means closing the warehouse. It usually doesn’t. We phase the install, working in sections, scheduling crane lifts and the loudest fabrication around your operations, and keeping part of the floor running. We sit down with the operations manager before any steel arrives and map the sequence so the disruption is contained.

The slab is the part nobody checks

Here’s a failure mode we catch more often than we’d like: the columns are sound, the steel is sized right, and then the column loads land on a slab that can’t take them. A freestanding mezzanine concentrates the platform’s entire weight onto a handful of baseplates, and an old warehouse slab in a Burnaby industrial building isn’t always thick enough, or reinforced enough, to carry those point loads without cracking or settling.

So part of designing a mezzanine is checking what’s under it. The engineer looks at the existing slab and the soil-bearing assumptions, and where the slab is marginal, we detail enlarged baseplates to spread the load or call for new footings cut into the slab. Skipping this is how a brand-new mezzanine ends up with cracked concrete and uneven columns a year later. It’s invisible in the quote and critical to the build.

Clear height: plan for both levels

The other thing owners underestimate is headroom. A mezzanine splits the existing volume into two usable layers, and both need enough clear height to work, people have to stand and move below the deck, and stand and work above it. The deck structure itself eats into that height, so a low-clearance unit can end up with one or both levels feeling cramped.

We work this out early. If the building has the height for it, great. If it’s tight, the deck system gets chosen partly for how shallow it can be built, a thinner composite deck buys back headroom a deep open-web joist system would consume. It’s the kind of thing that’s easy to fix on paper and impossible to fix after the steel is up, which is why we raise it before anything gets fabricated.

A mezzanine is one of the highest-return pieces of commercial metalwork we do, it converts dead air into working floor space at a fraction of the cost of relocating. The key is treating it as the engineered structure it is, from the load calc through the permit to the install. If your Burnaby or Coquitlam facility is running out of room, send us the floor area and what you want to put up there, and we’ll scope a platform that does the job and passes inspection.

Related topics

  • steel mezzanine Burnaby warehouse
  • structural platform Coquitlam industrial
  • mezzanine fabrication Metro Vancouver
  • warehouse floor space expansion steel
  • commercial steel mezzanine permit Burnaby

FAQ

Related questions

These FAQs are included only where the article topic naturally supports them.

What is a steel mezzanine and why would a Burnaby warehouse need one?

A steel mezzanine is a freestanding or building-supported intermediate floor that adds usable area above the existing slab without expanding the building footprint. In Burnaby and Coquitlam industrial zones, where land and lease space are expensive, a mezzanine is often the cheapest way to add storage, office, or production area inside an existing tilt-up or warehouse shell.

Does a steel mezzanine need a building permit in Metro Vancouver?

Yes. A mezzanine is a structural addition that requires a building permit and engineered drawings sealed by a professional engineer in every Metro Vancouver municipality we work in. The permit review looks at structural loads, the impact on the existing building, occupancy, and fire and egress requirements. Skipping the permit is how a mezzanine becomes a liability at the next inspection or sale.

How is the load capacity of a mezzanine determined?

A structural engineer sets the design load based on the intended use, light storage, heavy pallet storage, office, or equipment all carry different loads under the BC Building Code. The mezzanine framing, deck, columns, and footings are then sized to that load. You should never load a mezzanine beyond its engineered rating, and the rated capacity should be posted on the platform.

Is a mezzanine freestanding or does it attach to the building?

Both approaches exist. A freestanding mezzanine carries its own load down to its own columns and footings, which keeps loads off the existing structure and is often easier to permit in a leased Coquitlam unit. A building-supported mezzanine ties into existing columns or walls, which can save steel but requires checking that the existing structure can take the added load.

What does a mezzanine guardrail have to meet in BC?

The open edges of a mezzanine need a guard that meets the BC Building Code height and load requirements for the occupancy, plus a continuous graspable handrail on the access stair. For industrial platforms, the guard also has to resist horizontal loads from people and equipment. We fabricate the guard and stair as part of the mezzanine package so it all meets code as one system.

How long does it take to fabricate and install a steel mezzanine?

Timeline depends on size and complexity, but a typical warehouse mezzanine runs from engineered drawings through shop fabrication and install over several weeks. The permit review often takes as long as the fabrication. We sequence the shop work so the steel is ready when the permit clears, minimizing downtime in your Burnaby or Coquitlam facility.

Can a mezzanine be installed without shutting down my warehouse?

Often, yes, we phase the install to keep part of the floor operational, working in sections and scheduling the noisy or crane-dependent work around your operations. Full shutdown is rarely necessary for a standard mezzanine. We coordinate the sequence with your operations manager before the steel arrives on site.

What decking goes on top of a steel mezzanine?

Common choices are bar grating, steel-plate-and-concrete composite deck, or a structural deck with plywood and finish flooring for office use. The choice depends on the use, the fire rating required, and whether you need a smooth floor or want air and light to pass through. Each option changes the load and the framing, so it's decided with the engineer up front.

Does a mezzanine affect my building's fire and sprinkler requirements?

It can. Adding an intermediate floor changes the occupancy and can trigger requirements for sprinkler coverage below and above the deck, additional egress, and fire separations under the BC Building Code. This is reviewed during the permit process, and it's a major reason engineered drawings and a proper permit are essential rather than optional.

Can you build an office mezzanine as well as a storage one?

Yes. Office mezzanines need a solid deck, finished flooring, and often acoustic and HVAC considerations, while storage mezzanines prioritize load capacity and may use open grating. We've fabricated both for Metro Vancouver clients and detail the platform to the actual use rather than a generic spec.

How much does a steel mezzanine cost in Burnaby or Coquitlam?

Cost depends on square footage, design load, deck type, the number of stairs and access points, and whether it's freestanding or building-supported, plus engineering and permit fees that vary by municipality. There's no honest flat rate. [Request a quote](/request-a-quote/) with your floor area and intended use and we'll scope it properly.

Related reading

More fabrication topics from Jeff and Simon

Related articles from our blog on metalwork, fabrication, and project planning.

Get in touch

Need help applying this to a real project?

Use the article as background, then send the actual fabrication scope, municipality, drawings, or dimensions so Jeff and Simon can review the next step.
